Container Home Mistakes: 7 Costly Errors to Avoid in 2025
The ultimate guide to identifying and preventing the 7 most common (and expensive) errors in container home construction, from permit failures to structural disasters.
The dream of a container home is powerful: a cost-effective, sustainable, and stylish living space. But for the unprepared, this dream can quickly become a financial and logistical nightmare. The path is littered with pitfalls, and a simple oversight at the beginning can cascade into tens of thousands of dollars in repairs or, in the worst cases, a project that must be abandoned entirely.
We see it all too often: aspiring homeowners who are passionate and excited, only to be stopped by a failed inspection, a catastrophic structural problem, or a home that’s simply unlivable. These are not small “oops” moments; these are container home mistakes that can jeopardize your entire investment and safety.
As experts in the field, we believe that foreknowledge is your greatest defense. The single best way to ensure your project’s success is to build on a foundation of professional, code-compliant planning. This guide is designed to be your ultimate defensive checklist. We will walk you through the 7 most costly and common container home mistakes and, more importantly, explain exactly how to prevent them from the very start. Your success is our mission, and it begins with avoiding these critical errors.
Mistake #1: Ignoring Local Building Codes and Zoning (The Project Killer)
This is, without question, the single most catastrophic and project-ending mistake you can make. It’s the assumption that because a shipping container is a pre-built “box,” it somehow exists outside the laws of construction. This could not be further from the truth.
Many aspiring builders think they can buy a plot of land, drop a container on it, and start cutting windows. This approach leads to immediate and severe consequences: massive fines, stop-work orders, legal battles, and, in many jurisdictions, a court order to remove the entire structure from your property at your own expense. It’s a complete and total loss.
The Critical Difference: Zoning vs. Building Codes
New builders often confuse these two separate but equally important sets of rules. You must satisfy both.
- Zoning Laws: These rules, set by your local municipality, dictate what you can build and where. They govern land use. Zoning laws answer questions like: “Is a residential dwelling allowed on this property?” “What are the minimum square footage requirements?” “How far must the home be set back from the property lines?” “Are ‘accessory dwelling units’ (ADUs) permitted?”
 - Building Codes: These rules, often based on the International Residential Code (IRC) or International Building Code (IBC), dictate how you must build. They govern safety and structural integrity. Building codes answer questions like: “What is the minimum R-value for insulation in this climate?” “How must the foundation be constructed to handle frost heave?” “What are the requirements for egress windows and smoke detectors?” “How must structural loads be supported?”

A container home must be permitted as a permanent residential structure, and that means it will be scrutinized under the same lens as any traditional, stick-built home. In fact, because it’s an “alternative” building method, you can often expect more scrutiny from a building department that is unfamiliar with them.
How Professional Plans Prevent This Mistake
This is where the value of a permit-ready plan set becomes undeniable. You cannot walk into a building department with a sketch on a napkin. You must present a comprehensive set of construction documents that prove your proposed home is safe, structural, and compliant.
Our plans demonstrate compliance with national standards like the IRC, covering all critical components that inspectors will review:
- Structural Integrity: Detailed drawings showing how container modifications are reinforced.
 - Foundation Plans: Engineer-ready details for a code-compliant foundation.
 - Energy Efficiency: Specifications for insulation and fenestration (windows/doors) that meet energy code requirements.
 - Life Safety: Egress window sizing, smoke detector locations, and minimum room dimensions.

When you begin with a professional plan, you are signalling to your building department that you are a serious builder, not a hobbyist trying to cut corners. This builds immediate trust and sets a collaborative, professional tone for the entire project.
For a deeper dive into this topic, we highly recommend reading our guide on navigating container home building codes, and supplementing that knowledge by visiting the official International Code Council (ICC) website.
Mistake #2: Skimping on the Foundation (The Shifting Nightmare)
A 40-foot shipping container weighs over 8,000 pounds empty. When fully built out with framing, insulation, drywall, and furniture, you are looking at a 25,00In-stock0+ pound structure. The idea that you can simply “set it on some paving stones” is one of the most dangerous and costly container home mistakes.
A foundation’s job is not just to hold the house up; it’s to anchor it against soil movement, water, frost heave, and wind. An improper foundation will fail, and when it does, it creates a cascade of disasters.
Why This Is a “Costly” Mistake
An inadequate foundation is a ticking time bomb. Here’s what happens when it fails:
- Structural Racking: The container, which is only designed to be supported at its four corners, will twist and rack. This immense stress makes doors and windows impossible to open or close.
 - Cracked Finishes: Drywall will crack, tile will shatter, and flooring will buckle.
 - Broken Utilities: The shifting will shear plumbing (sewer and water lines) and put dangerous stress on electrical and gas connections.
 - The “Unfixable” Problem: Repairing a failed foundation is exponentially more expensive than doing it right the first time. It often involves lifting the entire house with cranes while a new foundation is built underneath—a truly catastrophic expense.

A Deep Dive: Common Foundation Options
Your foundation choice is dictated by your soil type, climate (especially the frost line), and budget. A geotechnical report from a local engineer is the only way to know for sure what your site needs. The most common options include:
| Foundation Type | Description | Pros | Cons |
|---|---|---|---|
| Concrete Piers | Deep concrete columns, often with steel reinforcement, are poured to support the four corners (and mid-points for 40ft+ spans). | Cost-effective, minimal site disturbance, good for slopes, elevates the home. | Requires precise placement, vulnerability to frost heave if not dug below the frost line. |
| Slab-on-Grade | A single, thick layer of concrete is poured on a prepared bed of gravel. The container is then anchored directly to the slab. | Very stable, provides a finished floor, excellent thermal mass. | More expensive, requires a level site, all plumbing must be placed before the pour. |
| Crawl Space / Perimeter Wall | A short foundation wall, similar to a traditional home, that lifts the container and creates an accessible space for utilities. | Excellent access for plumbing/electrical, very stable, isolates home from ground moisture. | More complex and costly than piers, can attract pests if not sealed. |
| Full Basement | A full-height foundation that creates an entire new level of living space beneath the container. | Massively increases square footage, all the benefits of a crawl space. | The most expensive and complex option, requires significant excavation. |
How Professional Plans Prevent This Mistake
Our plan sets treat the foundation as the critical system it is. We don’t just guess. Our plans include detailed, engineer-ready options that are designed to comply with IRC Chapter 4 (Foundations). They provide the exact specifications a local Professional Engineer (PE) needs to review and stamp for your specific site conditions. This non-negotiable step ensures your home will be stable, safe, and secure for decades. For more detail, see our complete guide to container home foundations.
Mistake #3: Disastrous Insulation & Condensation Management
A shipping container is a single-wall steel box. Steel is an excellent conductor of heat—meaning it’s terrible at insulation. Left unmanaged, this steel box will be an oven in the summer, an icebox in the winter, and a non-stop “sweat” machine all year round. This is not just a comfort issue; it is a structural and health catastrophe in the making.
The Science of the “Steel Sweat Box”
This is the most critical concept to understand: condensation. When your warm, moist interior air (from breathing, cooking, and showering) hits the cold surface of the steel container wall, it instantly condenses into liquid water. This is called the “dew point.”
If you put up interior framing and drywall before managing this, that water will form inside your walls. You won’t see it until it’s too late. This leads to:
- Rust: Your container will rust from the inside out, compromising its structural integrity.
 - Mold: Toxic black mold will flourish in the damp, dark wall cavities, creating a serious health hazard.
 - Rot: Your wooden or steel studs will rot or rust, and your insulation will become a soggy, useless mat.
 - Energy Bills: Your HVAC system will run 24/7, trying to fight a battle it cannot win, leading to astronomical energy bills.

This is all caused by thermal bridging—the process where the exterior cold or heat “bridges” directly into your home through conductive materials (like the steel walls and studs). The only way to stop this is to create a complete, unbroken thermal break.
The Code-Compliant Solution: R-Values and Climate Zones
The International Residential Code (IRC) Chapter 11 (Energy Efficiency) mandates minimum “R-values” (a measure of thermal resistance) for your walls, floors, and ceilings. These requirements vary by location. The U.S. is divided into 8 “Climate Zones,” and you must meet the standard for your specific zone.
The only truly effective way to insulate a container home and prevent thermal bridging is to use a method that creates a continuous barrier. By far, the most recommended solution is closed-cell spray foam (CCSF). It is expensive, but it solves three problems at once:
- High R-Value: It has a very high R-value per inch (around R-6.5).
 - Vapor Barrier: It is impermeable to air and moisture, completely sealing the interior air from the cold steel wall.
 - Structural: It adds to the rigidity of the wall.

Other options like insulation panels (EPS, XPS) or batts can be used, but they require meticulous attention to sealing every single joint and seam to prevent air gaps. A single gap defeats the purpose.
How Professional Plans Prevent This Mistake
You cannot guess your insulation. Our plan sets are designed with code-compliant energy efficiency in mind. We provide the insulation specifications (e.g., “3 inches of closed-cell spray foam”) and details that your building department needs to see to approve your plan. We have done the calculations to ensure your home will be comfortable, healthy, and compliant. Don’t make one of the worst container home mistakes; learn more in our ultimate container home insulation guide.
Mistake #4: Using a Damaged, Sub-Grade, or “Mystery” Container
The container itself is your “chassis.” It’s the most fundamental component of your build. A common mistake, driven by a desire to save money, is to buy the cheapest container available. This often means purchasing a “WWT” (Wind and Watertight), “As-Is,” or “Cargo Worthy” (CW) container that has lived a long, hard life.
This is a classic “penny wise, pound foolish” error. The $1,000 you “saved” on a cheaper box will be spent ten times over in repairs.
Why This Is a “Costly” Mistake
These older containers come with a host of expensive and dangerous problems:
- Structural Dents: We’re not talking about small dings. We mean large dents and bows in the corrugated sides or, even worse, in the top rails or corner castings. This compromises the entire structural integrity of the box.
 - Hidden Rust: What looks like “surface rust” can be deep, perforating rust that has weakened the steel. This is especially common on the roof and under the floor.
 - Hazardous Materials: The floors of most shipping containers are marine-grade plywood treated with harsh pesticides (like arsenic and insecticides) to protect cargo. The walls may be coated in lead-based paint. Remediation is a costly, hazardous-material-handling process.
 - Racked Frame: A container that has been dropped or improperly handled may no longer be “true” or square, making it impossible to level and build with.

The “One-Trip” Solution
The gold standard for container home construction is the “One-Trip” container. As the name implies, this container has made only one journey from its country of origin (usually Asia) carrying a single load of cargo. It is then sold upon arrival.
It is, for all intents and purposes, a new container. It will have pristine floors, no dents, perfect corner castings, and its original, intact paint.
| Container Grade | Description | Best Use Case | Risk Level for Home |
|---|---|---|---|
| One-Trip (New) | Used for one cargo load. Essentially new. | Ideal for all container homes. | Very Low |
| Cargo Worthy (CW) | Certified to be stacked and shipped. May have repairs, some rust, and dents. | Storage, non-structural projects. | Medium to High |
| WWT (Wind/Water Tight) | Guaranteed not to leak, but may have significant rust and dents. No structural guarantee. | Storage shed only. | Very High |
| As-Is | A container with significant damage. No guarantees of any kind. | Scrap metal. | Extreme / Unusable |
How Professional Plans Prevent This Mistake
While we can’t inspect your container for you, our plans are predicated on you starting with a structurally sound unit. All of our engineering, from window reinforcements to stacking loads, assumes you are using a container that meets its original factory specifications (i.e., a One-Trip). If you use a damaged, sub-grade container, the engineering in our plans is no longer valid. Starting with a One-Trip container is the first and most important investment you will make in your home’s safety and longevity.
Mistake #5: Botching Structural Modifications (The “Big Cut” Catastrophe)
A shipping container has a “monocoque” structure. This means its “skin” (the corrugated steel walls) and frame (the top/bottom rails and corner posts) work together as a single, unified structural system. It’s incredibly strong when intact.
The moment you cut a hole in it—whether for a window, a door, or to join two containers—you have compromised that structure. A catastrophic container home mistake is to start cutting these openings without a precise, engineered plan to redistribute the loads you’ve interrupted.
Why This Is a “Costly” Mistake
The corrugated steel walls are not just “siding”; they are the load-bearing elements that transfer forces (like the roof load) down to the frame. When you cut a large section out:
- Roof Sagging: The roof can begin to deflect or “sag” in the middle, as the wall that was holding it up is gone.
 - Wall Buckling: The remaining sections of the wall can buckle under the new, concentrated stress.
 - Total Structural Failure: In a multi-story build, this can lead to a complete collapse.

The “fix” is to weld in new steel—typically heavy-gauge square tubing—to create a “header” (above the opening) and “jambs” (on the sides) that frame the new hole. This new steel frame collects the load and transfers it properly down to the foundation. This is not optional, and it is not guesswork. The size of this new steel framing must be calculated by a structural engineer.
Pro-Tip: Welding is a Non-DIY Skill
Structural welding is not the same as hobbyist welding. This is an overhead, load-bearing weld that must be done perfectly to ensure the home’s safety. This work must be done by a certified welder. A failed weld is a failed house.
How Professional Plans Prevent This Mistake
This is, quite literally, what our plans are for. Every single opening you see in our designs—every window, every door, every pass-through—has been reviewed by a structural engineer. The plans include the exact reinforcement details required for that specific cut.
When you buy our plans, you are not just buying a floor plan; you are buying the pre-engineered solution to this exact problem. We show your builder precisely what size steel tubing to use and exactly how it must be welded in. We have taken the most dangerous and complex part of the build and provided a clear, safe, and code-compliant solution.
We’re often asked, “Can I move a window?” The answer is “yes,” but it requires an engineering review. If you love one of our designs but need to customize the openings, we offer a plan modification service after purchase. Just contact us for a quote, and we can work with you to make those changes safely and ensure the structural integrity is maintained.
Mistake #6: Ignoring Ceiling Height & Livability (The Claustrophobia Trap)
This is one of those container home mistakes that you don’t realize you’ve made until you’re standing in the finished room, and the ceiling feels like it’s an inch from your head. It’s a rookie error that permanently damages the “feel” and resale value of your home, and it might even get your project failed by an inspector.
The Math That Dooms Standard Containers
Here’s the problem. A “Standard” shipping container has an exterior height of 8 feet, 6 inches. This gives you an interior ceiling height of about 8 feet (96 inches). That sounds okay, right?
But wait. You must add:
- Floor Insulation: To meet code, you will have a subfloor with insulation. Let’s say this builds up your floor by 4-6 inches.
 - Ceiling Insulation: You must insulate the ceiling (see Mistake #3). This means framing and spray foam, which will easily consume another 4-6 inches.

Let’s do the math: 96 inches (original height) – 5 inches (floor) – 5 inches (ceiling) = 86 inches. That is 7 feet, 2 inches.
This is right on the hairy edge of the legal minimum. The International Residential Code (IRC Section R305.1) requires a minimum ceiling height of 7 feet (84 inches) for habitable spaces. You’ve left yourself zero room for error, lighting fixtures, or a ceiling fan. It feels cramped, claustrophobic, and cheap.
The “High Cube” Solution

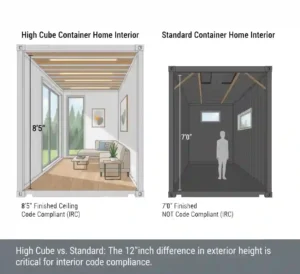

This mistake is 100% preventable by making one simple choice at the time of purchase: Buy a “High Cube” container.
A High Cube container has an exterior height of 9 feet, 6 inches—exactly one foot taller than a standard container. This gives you an interior height of about 9 feet (108 inches).
Let’s do the math again: 108 inches – 5 inches (floor) – 5 inches (ceiling) = 98 inches. That is 8 feet, 2 inches. This is a comfortable, spacious, and fully code-compliant ceiling height that feels like a real home, not a crawl space.
Yes, a High Cube container costs slightly more. But this is, without a doubt, the single best dollar-for-dollar upgrade you can make on your entire project. There is almost no situation where a standard container is the right choice for a home.
How Professional Plans Prevent This Mistake
Our plans are designed to be built with High Cube containers. We believe this is a non-negotiable component of a quality, livable container home. Our designs, our material lists, and our engineering all assume this 9’6″ starting height, ensuring the final product is spacious, comfortable, and fully compliant with the IRC’s minimum height requirements. We are helping you avoid this mistake by designing for the correct material from step one.
Mistake #7: Hiring an Inexperienced Contractor (or DIY-ing the Wrong Parts)
The final costly mistake is one of human error. The container home boom has attracted a lot of “green” builders who think it’s an easy job. They are wrong. A general contractor who has only ever built with wood (stick-built) is not automatically qualified to build with steel.
They often lack the specific, critical skills needed for a container project, leading to massive delays, blown budgets, and failed inspections.
Why This Is a “Costly” Mistake
An inexperienced builder (or an over-ambitious DIY-er) makes critical errors in three key areas:
- Welding: They underestimate the complexity of structural welding. Their welds are cold, weak, or incomplete, and they will be failed by an inspector, forcing a costly re-work.
 - Steel Fabrication: They don’t have the right tools (plasma cutters, heavy-duty grinders, levels for steel) and fight the project the whole way, taking 10x longer than a prepared team.
 - Code-Compliance: They don’t understand the unique challenges of insulation and vapor barriers (Mistake #3) and build your walls incorrectly, dooming the home to mold and rust.

The DIY vs. Pro Checklist: Know Your Limits
You can be your own General Contractor and save a lot of money, but you must be honest about your skills. You must “hire out” the parts that ensure safety and structural integrity.
| Task | Recommended: HIRE A PRO | Recommended: DIY-Friendly |
|---|---|---|
| Foundation & Geotechnical Report | ✅ | |
| Structural Welding & Steel Fabrication | ✅ | |
| Plumbing & High-Voltage Electrical | ✅ | |
| Closed-Cell Spray Foam Insulation | ✅ (Requires special_equipment) | |
| Interior Wood Framing | ✅ | |
| Painting & Staining | ✅ | |
| Installing Flooring (LVP, Laminate) | ✅ | |
| Installing Cabinets & Fixtures | ✅ |
How Professional Plans Prevent This Mistake
Our permit-ready plans are the single greatest tool you have for managing your contractor. They are the “universal translator.” They remove all guesswork and ambiguity. Your builder doesn’t need to “guess” how to frame a window; they just need to follow the detailed diagram.
A professional plan set protects you from inexperienced contractors by:
- Enabling Accurate Bids: You can hand 5 different builders the exact same set of plans and get back 5 “apples-to-apples” quotes.
 - Serving as a Legal Contract: The plans become part of your contract, with the builder agreeing to “build to print.”
 - Guiding Inspections: The plans give the building inspector the “answer key,” showing them exactly how you are meeting code, leading to faster, smoother approvals.

Don’t let your builder “wing it.” Give them the professional, detailed instructions they need to succeed on your behalf.
Your Blueprint for Success: Avoiding Mistakes with Professional Planning
We have covered the 7 most costly, and most common, container home mistakes. As you’ve seen, they all share a common theme: they are all failures of planning.
- Mistakes in Code.
 - Mistakes in Foundations.
 - Mistakes in Insulation.
 - Mistakes in Materials.
 - Mistakes in Structure.
 - Mistakes in Design.
 - Mistakes in Labor.

Every single one of these catastrophic errors can be anticipated and prevented. They are not “bad luck”; they are the predictable result of starting a complex construction project without a professional, comprehensive plan.
Your journey to a successful container home does not start with buying a container. It does not start with clearing land. It starts with a set of permit-ready, engineer-reviewed plans. This is your blueprint, your insurance policy, and your single greatest tool for success. We are here to help you start your project on the right foundation.
❓ Frequently Asked Questions
What is the single most expensive container home mistake?
The most expensive mistake is ignoring local building codes and zoning (Mistake #1). This is the only mistake that can result in a 100% total loss of your investment, where a court may order you to demolish and remove the entire structure at your own cost, leaving you with nothing but the debt.
Do your plans automatically prevent all these mistakes?
Our plans are a critical tool designed to prevent these mistakes. They provide the correct, code-compliant solutions for foundations (Mistake #2), structural modifications (Mistake #5), and livability (Mistake #6). They also include the necessary details for insulation (Mistake #3) and are designed for use with quality containers (Mistake #4). However, the plan must be followed by a competent builder (Mistake #7) and approved by your local department (Mistake #1). The plan is your blueprint for success.
Why do I still need a local Professional Engineer (PE) stamp if your plans are “permit-ready”?
This is an excellent question! We frame this as a positive and necessary step for your safety. Our plans are “permit-ready” because they are designed to 99% completion, making the PE’s job easy, fast, and affordable. Your local PE provides the crucial “final check” that adapts our robust design to your specific site. They will review your local soil report, frost line depth, and snow load requirements, and then “stamp” the plans, certifying for your building department that the design is safe for your exact location. This process is a standard, collaborative part of any safe build and is your ultimate protection.
Is it ever okay to use a “Standard” (8’6″) container instead of a “High Cube” (9’6″)?
While “never” is a strong word, it is highly inadvisable for a habitable dwelling. As we outline in Mistake #6, after you add code-compliant insulation to the floor and ceiling, you are left with a ceiling height that is barely legal and feels claustrophobic. The small extra cost for a High Cube container provides an enormous return in livability, comfort, and resale value. We always recommend High Cube containers.
Ready to Start Your Build?
Don’t learn from costly errors. Start your project with confidence by using a professional, permit-ready plan designed to prevent these mistakes from day one.
Browse All PlansIf you love a design but need to move a window, we offer a plan modification service after purchase to help you customize it. Just contact us for a quote!
Important: Our plans are permit-ready but require review and stamping by a local licensed Professional Engineer (PE) in your jurisdiction. Final approval is subject to local building codes and regulations. We recommend consulting your local building department to verify all requirements.
Financial Disclaimer: Costs vary significantly by location, site conditions, and material choices. These are estimates for planning purposes only.
Refund Policy: Due to the digital nature of our plans, all sales are final. Please review our Refund Policy for details.
